R&D and Project Management in Computer Science (11117BLG002), week 9 of 14

Scheduling: Critical Path and PERT

Prof. Dr. Utku Kose, Süleyman Demirel University

Overview

Once tasks and dependencies are known, the schedule follows from arithmetic. This week introduces network diagrams, the critical path method and PERT, and discusses how schedules can be compressed and where their assumptions fail [1, 2, 3].

Estimated study time: 6 to 8 hours.

Learning outcomes

By the end of the week, students are expected to draw a dependency network, to compute earliest and latest start and finish times and total float, to identify the critical path, to compute the probability of meeting a deadline with PERT, and to explain crashing, fast tracking and the limits of PERT.

Study path

Step Activity Suggested time
1 Read the lecture below or the PDF version 90 minutes
2 Explore the interactive lab 45 minutes
3 Work through the Colab notebook and its exercises 2 to 3 hours
4 Take the self-assessment in the lab (tab: Check yourself) 20 minutes
5 Write the reflection, export the learning log and complete the weekly task 60 minutes

Week at a glance

flowchart LR
  A["A Literature review 3"] --> D["D Method design 4"]
  B["B Data access 2"] --> C["C Data collection 5"]
  C --> E["E Prototype 6"]
  D --> E
  D --> F["F Benchmark design 2"]
  E --> G["G Experiments 4"]
  F --> G
  G --> H["H Paper writing 3"]
  G --> I["I Workshop 2"]

Lecture

Networks of tasks

A schedule begins with dependencies. In an activity-on-node network, each task is a node and an arrow from one task to another means that the second depends on the first. The most common dependency is finish-to-start, in which a task can start only when its predecessor has finished; start-to-start, finish-to-finish and start-to-finish dependencies describe other relations. In research projects, dependencies often run through approvals and data: Experiments cannot start before data access is granted, and a user study cannot start before ethics approval.

Check your understandingWhat does a finish-to-start dependency between tasks A and B mean?

Explore while reading. The interactive lab of this week can be opened inside this page or next to the text, so that ideas can be tried out as they are introduced.

The critical path method

Kelley and Walker described the critical path method for planning and scheduling projects [1]. A forward pass through the network computes the earliest start and finish of every task: A task starts as soon as all its predecessors have finished. A backward pass from the project end computes the latest start and finish that do not delay the project. The difference between latest and earliest start is the total float, the delay a task can absorb without delaying the project. Tasks with zero float form the critical path, the longest path through the network, whose length is the project duration. Figure 9.1 shows the schedule of a small research project with two critical paths that merge before the experiments.

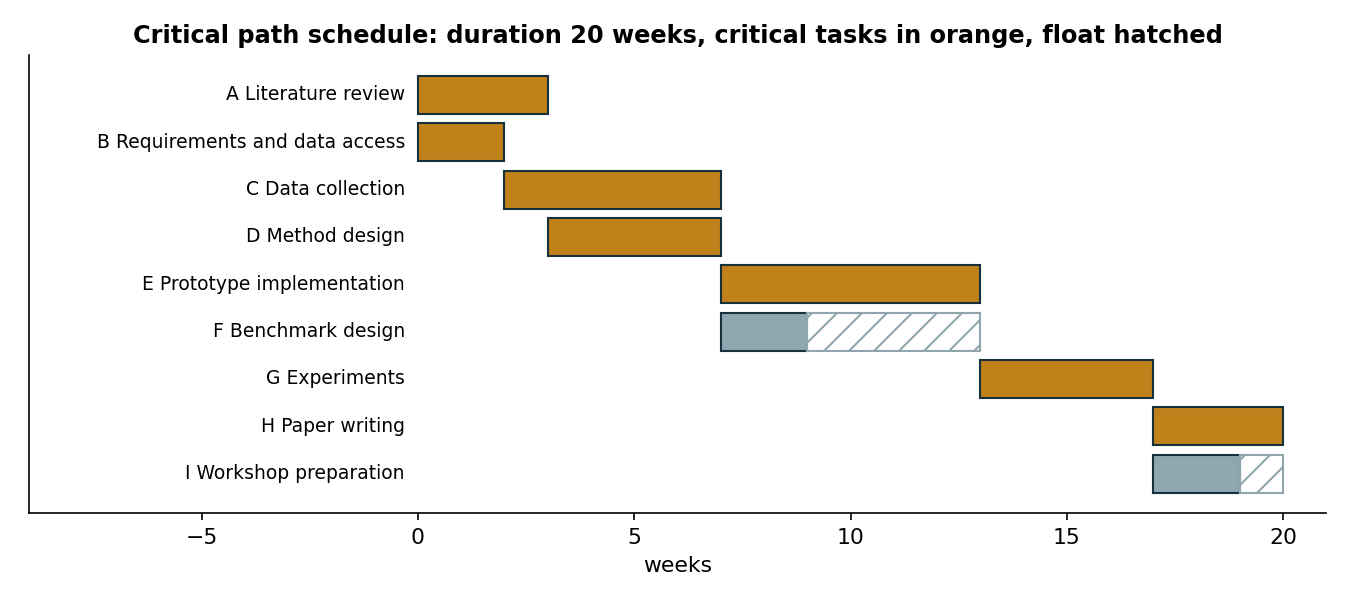

Critical path schedule of the example research project: two critical paths of 20 weeks merge at the prototype; benchmark design and workshop preparation have float {cite:kelley1959}.

Figure 9.1. Critical path schedule of the example research project: two critical paths of 20 weeks merge at the prototype; benchmark design and workshop preparation have float [1].

Check your understandingWhich tasks form the critical path?

PERT and the probability of meeting a deadline

PERT was developed for the research and development programme of the Polaris missile system [2]. It combines the network with three-point estimates: The expected duration of the project is the sum of the expected durations on the critical path, and its variance is the sum of their variances, if tasks are independent. With a normal approximation, the probability of finishing by a deadline follows. The method has a known weakness: It considers only one critical path, so it ignores the chance that a near-critical path becomes critical. When paths merge, the expected completion time is later than PERT suggests. Week 10 addresses this merge bias with Monte Carlo simulation.

Check your understandingWhy does classical PERT tend to be optimistic?

Compressing a schedule

When the computed duration exceeds the time available, the schedule can be compressed. Crashing adds resources to critical tasks to shorten them, at extra cost; fast tracking overlaps tasks that were planned in sequence, at extra risk [3]. Shortening a non-critical task gains nothing, and shortening a critical task can make another path critical. In research projects, the most effective compression is often to start long administrative tasks, such as data agreements and ethics applications, as early as possible.

Pause and reflect. Which task of your project lies on the critical path, and what could you start earlier to protect it?

Check your understandingWhat is the difference between crashing and fast-tracking?

Interactive lab

Edit the task list, one task per line: identifier, name, duration in weeks and predecessors separated by spaces. The calculator performs the forward and backward passes, marks the critical path and estimates the probability of meeting a deadline with PERT [1, 2].

Open the interactive lab

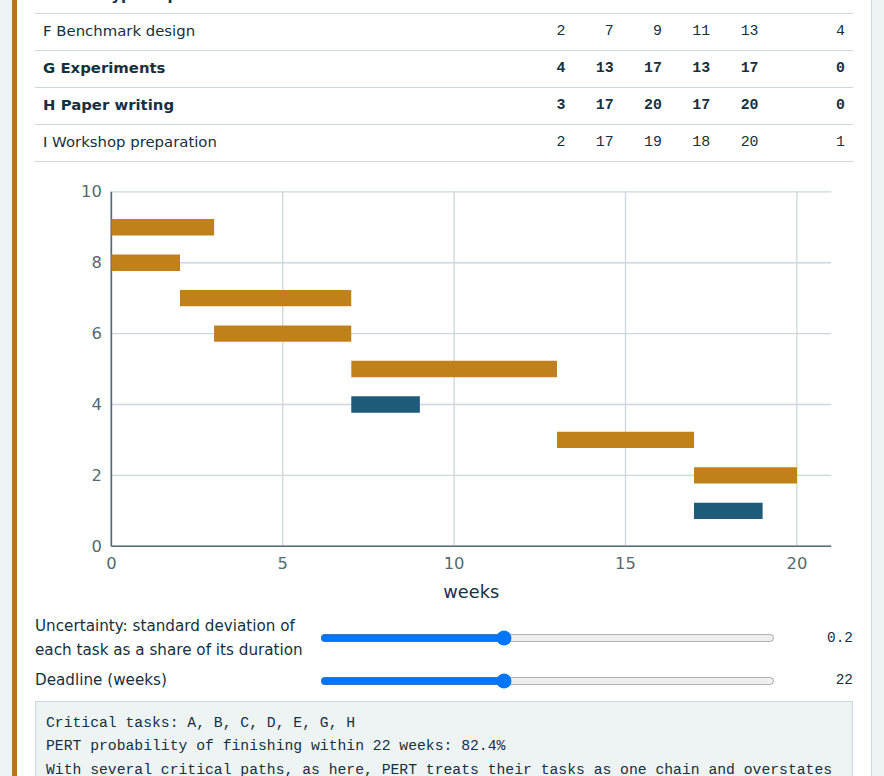

Screenshot of the Week 9 interactive lab

Colab notebook

The notebook implements the critical path method, computes the float of every task and estimates the probability of meeting a deadline with PERT [1, 2].

Open in Colab

Screenshots of the executed notebook:

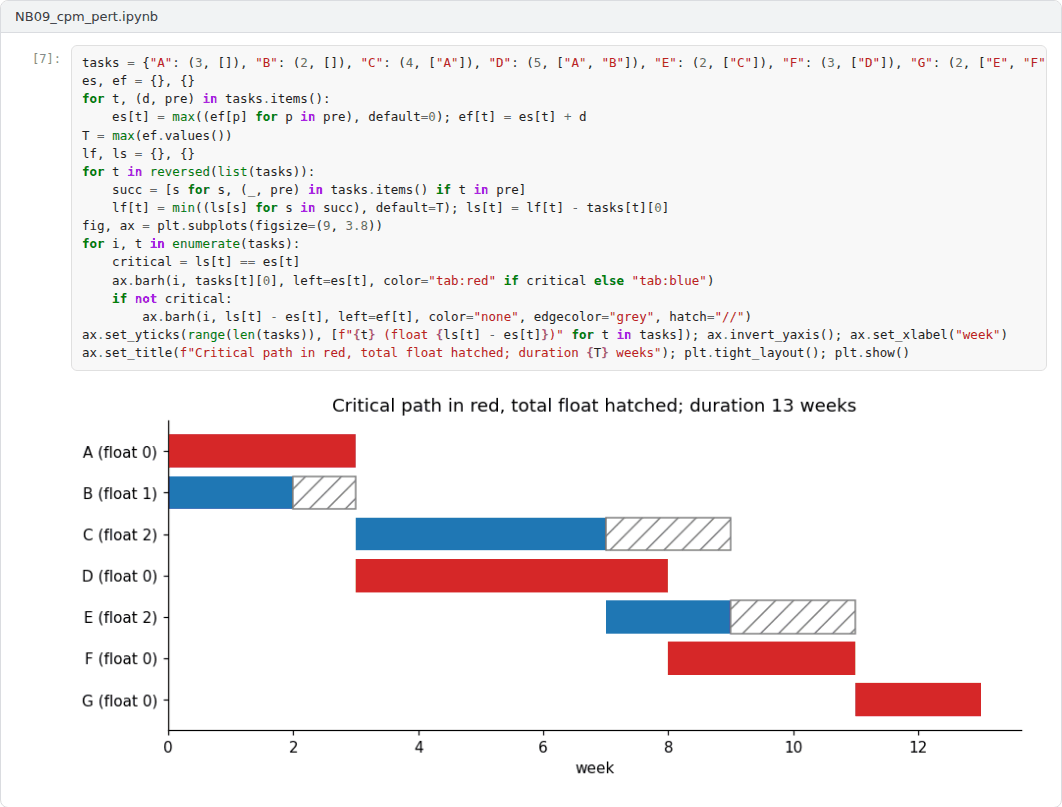

Output 1 of the Week 9 notebook

Self-assessment and reflection

The lab contains a 6-question self-assessment with instant feedback and a confidence rating for each answer. A confident but wrong answer marks the first topic to revisit. The reflection prompts below are also available in the lab, where answers are saved in the browser and can be exported as a learning log.

  1. Enter your own project in the calculator. Which task on the critical path is most uncertain?
  2. Where in your project could fast tracking create more risk than it saves time?
  3. Why do administrative tasks so often lie on the critical path of research projects?

Weekly task and submission

Build the dependency network of your project, compute the critical path and float with the calculator or the notebook, and include the schedule figure in your proposal draft. State the probability of meeting the planned end date under PERT and explain its limitation. Attach the notebook with both exercises completed.

The weekly task supports self-learning and builds a personal portfolio. When the course is followed with the instructor during an active semester, the task can be sent together with the exported learning log to utkukose@sdu.edu.tr or utkukose@gmail.com for evaluation.

Research and report assignment (optional)

Scheduling beyond the critical path. Review scheduling approaches that extend the critical path method, such as resource-constrained scheduling and buffer management, and assess their suitability for research projects [1, 2, 3].

This research assignment is optional and supports self-learning. When the related weeks are followed within the course during an active semester, the report can be sent to utkukose@sdu.edu.tr or utkukose@gmail.com for evaluation. Unless the assignment states otherwise, a report has 1500 to 2500 words, follows the structure of an academic paper, cites at least six scholarly or official sources in square brackets and ends with a reference list.
