R&D and Project Management in Computer Science (11117BLG002), week 11 of 14

Agile Methods in Research and Development

Prof. Dr. Utku Kose, Süleyman Demirel University

Overview

Plans made at the start of a research project rarely survive contact with results. This week introduces the values of agile development, the Scrum framework, Kanban and the law that links work in progress to cycle time. It also discusses how iterative methods can work inside grant agreements with fixed deliverables [1, 2, 3].

Estimated study time: 6 to 8 hours.

Learning outcomes

By the end of the week, students are expected to explain the values and principles of agile development and to describe the accountabilities, events and artefacts of Scrum. They should be able to apply Little's law to a team's flow of work and to forecast delivery from past velocity. Finally, they should be able to design a hybrid approach for a funded research project.

Study path

Step Activity Suggested time
1 Read the lecture below or the PDF version 90 minutes
2 Explore the interactive lab 45 minutes
3 Work through the Colab notebook and its exercises 2 to 3 hours
4 Take the self-assessment in the interactive lab (tab: Check yourself) 20 minutes
5 Answer the reflection prompts in the interactive lab, export the learning log and complete the weekly task 60 minutes

Week at a glance

flowchart LR
  V["Agile values and principles"] --> S["Scrum: accountabilities, events, artefacts"]
  V --> K["Kanban: visualise, limit work in progress, manage flow"]
  K --> L["Little's law: cycle time = WIP / throughput"]
  S --> F["Velocity forecasts"]
  G["Grant frame: work packages and milestones"] --> H["Hybrid: iterations inside the frame"]

Lecture

Agile values

In 2001, a group of software practitioners published the Manifesto for Agile Software Development [1]. It values individuals and interactions over processes and tools, and working software over comprehensive documentation. It also values customer collaboration over contract negotiation, and responding to change over following a plan. It still recognises value in the items on the right. Twelve principles elaborate these values, among them the frequent delivery of working software and regular reflection on how to become more effective. Dingsøyr and colleagues reviewed a decade of research on agile methods and argued that the field needed stronger theoretical foundations to explain why and when the methods work [4].

Check your understandingWhich value appears in the Agile Manifesto?

Explore while reading. The interactive lab of this week can be opened inside this page or next to the text, so that ideas can be tried out as they are introduced.

Scrum

The Scrum Guide describes Scrum as a lightweight framework for addressing complex problems [2]. A Scrum Team has three accountabilities. Developers create the increment, and a Product Owner maximises the value of the product and manages the Product Backlog. A Scrum Master helps the team use Scrum effectively. Work proceeds in Sprints of one month or less, each with Sprint Planning, a Daily Scrum, a Sprint Review and a Sprint Retrospective. The three artefacts, the Product Backlog, the Sprint Backlog and the Increment, carry commitments: the Product Goal, the Sprint Goal and the Definition of Done. The velocity of past Sprints supports forecasts, which the interactive lab turns into probability distributions.

Check your understandingWhat is the product owner accountable for in Scrum?

Flow and Little's law

Kanban, as described by Anderson, makes work visible on a board, limits the work in progress and manages the flow of items through the system [5]. Little proved that, in a stable system, the average number of items in the system equals the arrival rate times the average time an item spends in it [3]. For a team, this means that the average cycle time equals the average work in progress divided by the throughput. If throughput is limited by the team's capacity, starting more work does not finish more work; it only makes each item take longer, as Figure 11.1 shows. Researchers who work on many papers and tasks at once experience the same effect.

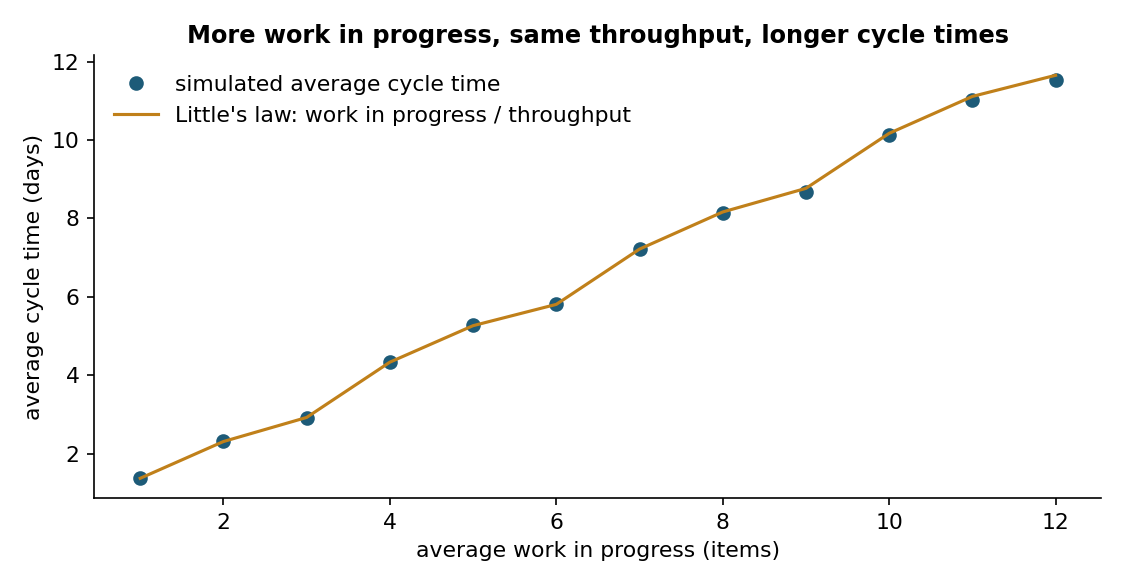

Simulated Kanban system with fixed capacity: raising the limit on work in progress leaves throughput unchanged and lengthens cycle times, as Little's law predicts.

Figure 11.1. Simulated Kanban system with fixed capacity: raising the limit on work in progress leaves throughput unchanged and lengthens cycle times, as Little's law predicts [3].

Check your understandingA team finishes 2 items per day on average and keeps 10 items in progress. What is the average cycle time?

Agile inside a research grant

Research projects combine a fixed structure, with work packages, deliverables and milestones agreed with the funder, and uncertain content, since results determine the next steps. Marchesi and colleagues described the use of a distributed form of Scrum to manage a European research project that developed an agent-based software platform [6]. They argued that research projects are complex and must be adapted continuously. A common hybrid keeps the work packages and milestones of the grant as the stable frame and runs iterations inside them. The iterations use a backlog of hypotheses, experiments and software tasks, short cycles with reviews against the objectives, and limits on work in progress. Changes that affect deliverables still follow the funder's amendment rules.

Pause and reflect. How many research tasks do you have in progress now? What does Little's law predict about their completion?

Check your understandingHow can agile methods be used inside a research grant?

Interactive lab

Part A simulates a team whose capacity is shared among the items in progress and checks Little's law. Part B forecasts the number of Sprints needed for a backlog from past velocities. Part C sorts the elements of Scrum [2, 3].

Open the interactive lab

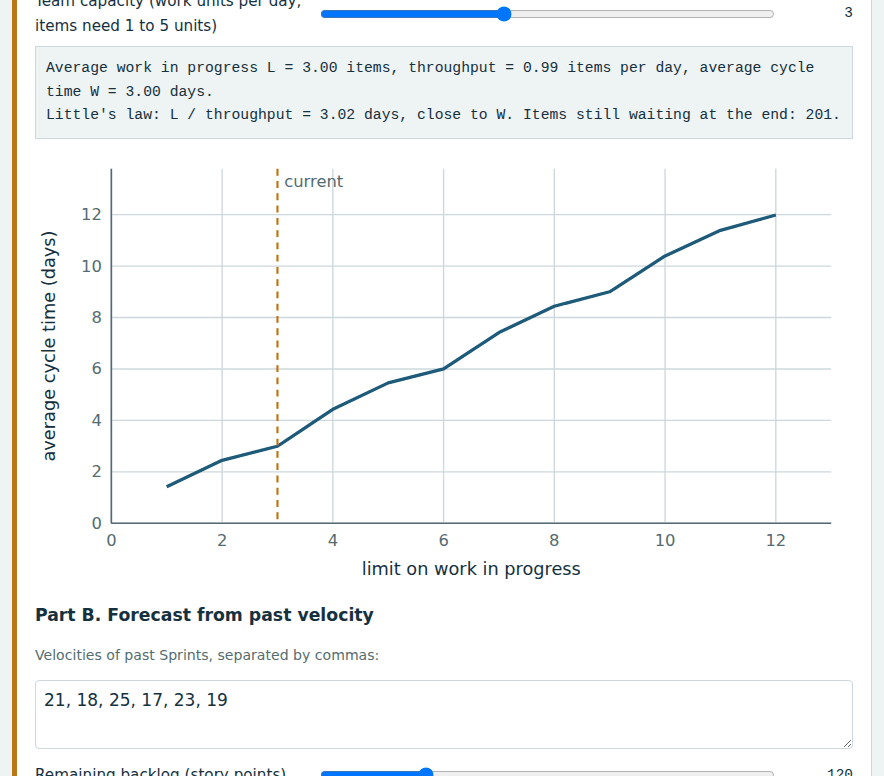

Screenshot of the Week 11 interactive lab

Colab notebook

The Colab notebook simulates a Kanban system to check Little's law and forecasts the number of Sprints needed for a backlog by resampling past velocities [2, 3].

Open in Colab

Screenshots of the executed Colab notebook:

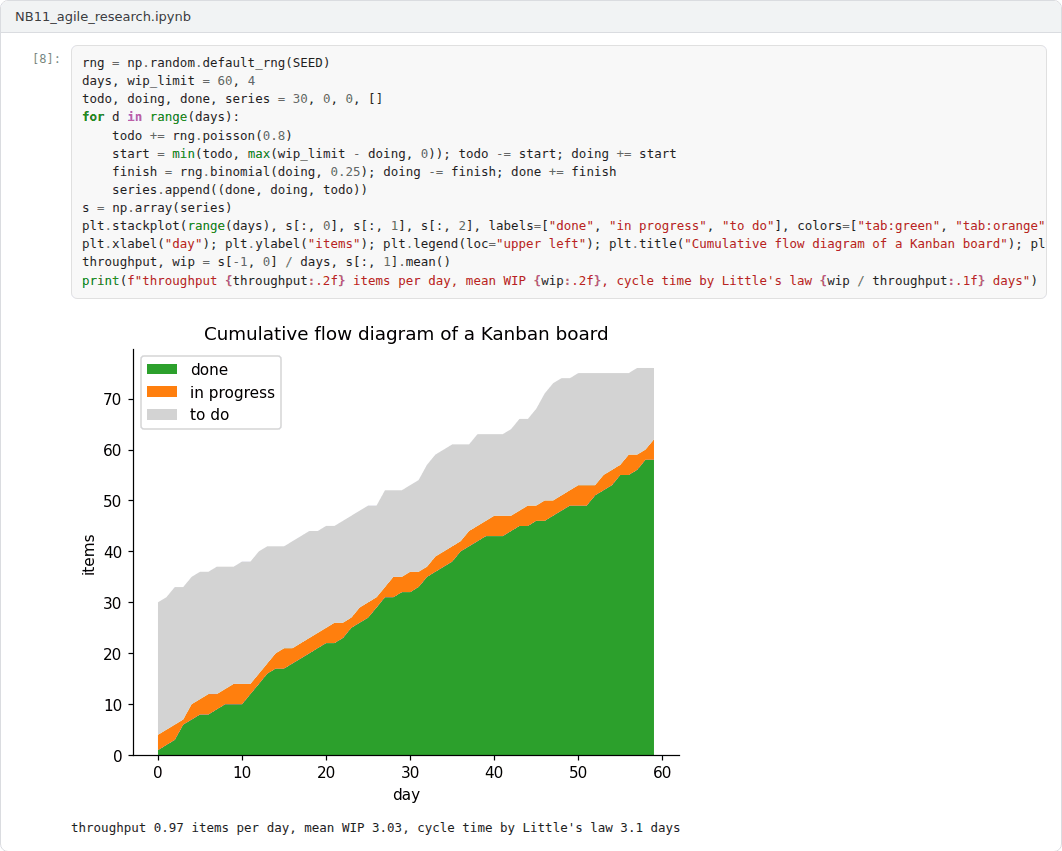

Output 1 of the Week 11 Colab notebook

Self-assessment and reflection

The interactive lab contains a self-assessment of six questions (tab: Check yourself). Students answer each question, state how sure they are and receive instant feedback. A confident but wrong answer marks the first topic to revisit. The reflection prompts below also appear in the interactive lab (tab: Reflect and submit). Answers written there are saved in the browser and can be exported as a learning log.

  1. Which of your current tasks would you stop or pause to reduce your work in progress, and what would you expect to happen?
  2. What would a Definition of Done look like for an experiment or a paper in your group?
  3. Where does a grant agreement constrain agile work most in your experience, and how could the frame be designed to leave room for learning?

Weekly task and submission

What to do. Design the working method of your project. Describe five elements: the stable frame that the grant fixes, the backlog, the length of an iteration, the limit on work in progress and the Definition of Done for experiments, software and papers. Then forecast how many iterations one work package needs, based on past or assumed velocities.

Where to look. Lecture: sections "Scrum", "Flow and Little's law" and "Agile inside a research grant". Interactive lab: Part A for work in progress and cycle time, and Part B for the forecast from past velocity. Colab notebook: Section 2 with Exercise 2, which forecasts the number of Sprints by resampling past velocities.

Example. A Definition of Done for an experiment could require version control for the code, fixed random seeds and results logged with the version of the data. A backlog of 60 points with past velocities of 8 to 12 points needs about 6 iterations on average, but a forecast at the 85th percentile may need 7.

What to submit. A description of about one page with the forecast, and the Colab notebook with Exercises 1 and 2 completed.

The weekly task supports self-learning and builds a personal portfolio. In an active semester, students who follow the course with the instructor can send their work for evaluation to utkukose@sdu.edu.tr or utkukose@gmail.com. The e-mail contains the items that the task lists under What to submit. It also includes the learning log exported from the interactive lab (tab: Reflect and submit).

Research and report assignment (optional)

Agile methods under fixed contracts and grants. How can agile methods work when scope or funding is fixed?

What to do. Review studies of agile methods in settings with fixed scope or funding agreements [4, 6]. Derive recommendations for research projects.

Where to start. Lecture section "Agile inside a research grant" and the study of Marchesi and colleagues [6].

Example focus. The report could ask how the role of a Product Owner can work when the deliverables are fixed in a grant agreement.

This research assignment is optional and supports self-learning. In an active semester, students who follow these weeks with the instructor can send the report for evaluation to utkukose@sdu.edu.tr or utkukose@gmail.com. The report has 1500 to 2500 words and follows the structure of an academic paper. It cites at least six scholarly or official sources in square brackets and ends with a reference list. The report template shows a suitable structure.

References

[1] Beck, K., Beedle, M., van Bennekum, A., et al. (2001). Manifesto for Agile Software Development. https://agilemanifesto.org

[2] Schwaber, K., & Sutherland, J. (2020). The Scrum Guide: The Definitive Guide to Scrum: The Rules of the Game. https://scrumguides.org

[3] Little, J. D. C. (1961). A proof for the queuing formula: L = λW. Operations Research, 9(3), 383-387. https://doi.org/10.1287/opre.9.3.383

[4] Dingsøyr, T., Nerur, S., Balijepally, V., & Moe, N. B. (2012). A decade of agile methodologies: Towards explaining agile software development. Journal of Systems and Software, 85(6), 1213-1221. https://doi.org/10.1016/j.jss.2012.02.033

[5] Anderson, D. J. (2010). Kanban: Successful Evolutionary Change for Your Technology Business. Blue Hole Press.

[6] Marchesi, M., Mannaro, K., Uras, S., & Locci, M. (2007). Distributed Scrum in research project management. In Agile Processes in Software Engineering and Extreme Programming (XP 2007), Lecture Notes in Computer Science 4536 (pp. 240-244). https://doi.org/10.1007/978-3-540-73101-6_45
